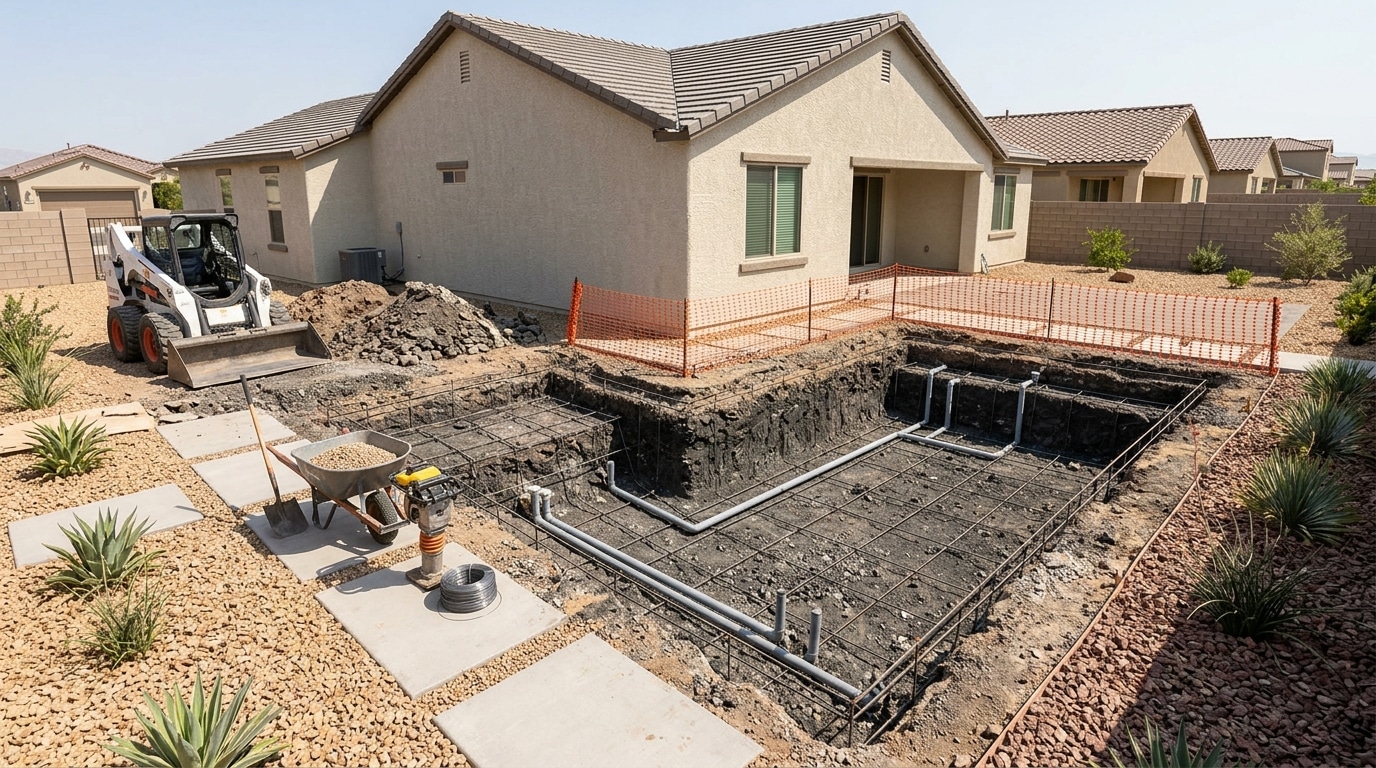

Pool Resource · Clark County

Two Permits Required Before Any Las Vegas Pool Excavation Can Begin

Clark County structural permit and SNWA clearance run in parallel — we file both from day one.

Clark County Structural Permit
SNWA Water Clearance
Electrical Bonding Inspection
Filed Under #0090486
Two Approvals, Day One

Every Las Vegas Pool Needs Two Government Approvals Before Ground Breaks

Every Las Vegas pool project requires two separate approvals before a single shovel breaks ground.

Clark County Pool Structural Permit

The building permit covering excavation, reinforced shell construction, plumbing rough-in, electrical bonding, and barrier installation — every physical element of the build.

SNWA Water Feature Clearance

A separate approval from the Southern Nevada Water Authority reviewing the water volume tied to your pool’s initial fill and estimated annual evaporation, on a completely independent track.

Parallel, Not Sequential

Both approvals must be confirmed before excavation can legally begin, and filing them on parallel tracks — not sequentially — is what keeps your project on schedule. For what SNWA reviews and what happens when clearance is filed late, see our pool construction service page.

A Water-Restricted Region

Why Las Vegas Pool Permitting Works Differently Than Almost Anywhere Else

Las Vegas sits inside one of the most water-restricted regions in the United States — and that changes how pool permits work here.

The Southern Nevada Water Authority manages water allocation across the entire valley. A homeowner in Phoenix, Denver, or even Reno doesn’t face a dual-track permit requirement — it’s specific to Southern Nevada, and it means both applications must be submitted from day one, not sequentially.

Clark County’s permit volume matters too. The valley’s residential building stock — much of it built rapidly between 1990 and 2008 — means the Building Department processes high permit volumes year-round. A complete, accurate application the first time reduces time in the review queue; resubmittals after a plan check correction add weeks.

Track 1

The Clark County Pool Structural Permit

The primary building permit governs every physical element of construction — excavation, shell, plumbing, bonding, and barrier.

The application requires the following before plan check can clear it:

Bonding Clears Before the Deck Pours

That last item carries its own inspection. The Electrical Bonding Inspection verifies every metal component in and around the pool is interconnected to prevent a voltage difference that could cause shock. It happens during rough-in, before the deck is poured — and if it’s missed or fails, the deck cannot go down.

The Inspection Sequence

The Clark County Pool Permit Inspection Sequence

Four required field inspections — each must pass before the next phase proceeds.

01

Pre-Gunite Inspection

After excavation and rebar installation, before the gunite or shotcrete shell is sprayed. Confirms rebar placement, spacing, and depth match the approved plans — schedule it immediately after rebar is set, because the shell can’t legally be applied until it clears.

02

Rough Plumbing & Electrical Bonding

After rough plumbing lines and the bonding grid are installed, before the shell is plastered or decking is poured. All metallic components — pump motor, filter housing, light niches, handrails — must be bonded and verified at this stage.

03

Barrier & Fence Inspection

Under NRS 444B, the physical barrier must be installed and inspected before the pool is filled. Verifies fence height (typically 60 inches in Clark County), gap clearances, and self-latching gate hardware, and must pass before the fill date is confirmed.

04

Final Inspection

After plaster, deck, equipment installation, and all finish work, a final inspection closes the Clark County permit and the certificate of completion is issued.

Track 2

The SNWA Water Feature Clearance

The SNWA clearance runs independently of the Clark County permit, on its own review cycle.

SNWA reviews the proposed pool’s water volume, its location on the parcel, and the property address as part of the regional SNWA Water Conservation Program. The clearance is tied to the specific property address and becomes part of the project’s permanent record.

Filing the SNWA clearance application at the same time as the Clark County permit — not after Clark County approves — eliminates the most common cause of excavation delay. Both tracks run simultaneously, and both are confirmed before any ground is broken.

Where Homeowners Get Stuck

Three Situations That Create Real Delays in the Permit Process

Each one is avoidable if you know it’s coming.

Excavation Before SNWA Clearance

The Clark County permit is submitted and excavation booked six weeks out, but SNWA clearance — on a separate track — wasn’t filed. Clark County approves on schedule; excavation day arrives with SNWA still pending, and the project sits. A sequencing error, eliminated by filing both on day one.

Barrier Inspection vs. Fill Date

The shell is plastered and deck poured, and the homeowner’s ready to fill — but the barrier fence went in without scheduling the Clark County barrier inspection. Filling before it passes is a violation under NRS 444B. Schedule the inspection right after fence installation, not when you’re ready to fill.

Pre-Gunite vs. the Gunite Crew

Rebar is set and the gunite crew is booked for the next morning, but the pre-gunite inspection wasn’t called in. Spray before the inspector clears the rebar and the work is unpermitted at that phase — he may require exposing shell sections at the owner’s cost. Call it in right after rebar is set.

From the Contractor's Side

What This Process Looks Like From the Contractor's Side

The permit process isn’t background paperwork — it’s the scaffolding the entire construction sequence runs on.

From the Founder

I’m Isaac Itzhaki, founder of 1 Home Construction, building pools and managing permits in Clark County since 2004. When we take on a pool project, both the Clark County structural permit application and the SNWA water feature clearance go out the same day. That’s non-negotiable in how we run projects — the Clark County plan check and the SNWA review operate on completely independent cycles, and neither agency coordinates with the other on your behalf. If one application lags, you absorb every day of that gap as idle project time.

What most homeowners don’t see is the plan check correction process. When Clark County issues a correction notice — a request for additional detail or a revision to drawings — the response window matters. We hold General Construction License #0090486 and file as the contractor of record, so corrections get a same-day response from us, not through a third-party service that batches them.

Two Questions That Tell You a Lot

Understanding this before you hire gives you a real way to evaluate contractors: ask how they handle plan check corrections, and ask whether they file both permits on the same day. The answers tell you whether your project will move or sit.

Isaac Itzhaki

Founder, 1 Home Construction LLC

When to Bring In a GC

When to Bring a Licensed GC Into Your Las Vegas Pool Project

Involve a licensed general contractor before the first permit application is submitted.

The dual-permit process creates a filing and tracking obligation from the project’s first day. A licensed GC of record manages both tracks, responds to plan check corrections, schedules each inspection in the required sequence, and confirms no phase advances until the prior inspection clears — pre-gunite before the shell is sprayed, bonding before the deck is poured, barrier before the pool is filled.

Nevada Pool Barrier Law (NRS 444B) compliance is a condition of the final inspection, not a checklist item addressed at the end — a licensed GC confirms barrier specifications against current Clark County requirements before the fence goes in. For any inground pool permit in the valley, the right time to involve a licensed contractor is at the design and site-plan stage, before a single application is submitted.

Areas We Serve

Pool Permits Managed Across Clark County

1 Home Construction builds pools and manages pool permits across all of Clark County, Nevada.

Every pool project includes both Clark County structural permit management and SNWA water feature clearance filing — filed directly and tracked through our office, without routing through third parties.

Las Vegas
Henderson
North Las Vegas
Summerlin
Southwest Valley
Green Valley
Anthem
Enterprise
Spring Valley
Paradise

Start Your Las Vegas Pool With Both Permits Filed From Day One

We manage the Clark County pool permit and SNWA water feature clearance simultaneously on every pool project — based in Las Vegas, filing both applications directly and tracking each approval through our office. Tell us your project and we’ll get both tracks running from the first submission.
